When the 60-Day Cancellation Notice Becomes a 12-Month Trap
Companies discover platform limitations at Month 6, start evaluation immediately, but still miss the November cancellation deadline. The 60-day notice period is structurally shorter than the 150-240 day timeline required for informed platform switching decisions.

A mid-market B2B company signs an annual contract with their email marketing platform in January. By June, the marketing team realizes the platform cannot support the advanced segmentation logic required for their new product launch. The IT director immediately initiates an evaluation process for alternative solutions. Demos are scheduled with three vendors by mid-July. A proof of concept begins in September with the top two candidates. By October, the team is still testing integration compatibility and data migration complexity. On November 1st, the contract's 60-day cancellation deadline passes. The company is now locked into another full year with a platform they know does not meet their needs, despite having started the evaluation process the moment the problem became apparent.
This scenario plays out across thousands of companies every year, not because procurement teams forget renewal dates or fail to plan ahead, but because of a fundamental structural mismatch between the cancellation notice periods written into SaaS contracts and the actual timeline required to make an informed platform switching decision. The 60-day notice window that seems perfectly reasonable during contract negotiation becomes an insurmountable barrier when the operational reality of platform evaluation collides with contractual deadlines.
Why Cancellation Windows Seem Reasonable
When procurement teams negotiate SaaS contracts, their attention naturally focuses on the terms that appear to carry the most financial and operational weight. They scrutinize per-contact pricing tiers, negotiate volume discounts, review service level agreements, and assess feature limitations across different plan levels. The cancellation notice period, typically buried in the renewal and termination section of the contract, receives far less attention. A 60-day notice requirement feels administratively reasonable. It provides the vendor with adequate time to adjust their revenue forecasts and capacity planning, while seemingly giving the customer ample opportunity to communicate their intent to leave.
The assumption underlying this casual treatment of cancellation clauses is that the decision to switch platforms is primarily an administrative act. Once leadership decides the current platform no longer serves the company's needs, the thinking goes, someone simply needs to send a cancellation notice within the specified window. This framing treats platform switching as a discrete event rather than an extended process, and it fundamentally misunderstands how enterprise software decisions actually unfold within organizations.
The cancellation notice period also appears reasonable because it is evaluated in isolation, without mapping it against the operational timeline required to reach the decision it governs. During initial contract negotiations, the company has no platform in place, or is actively dissatisfied with their current solution, which means they have already completed the evaluation process that led them to this particular vendor. The 60-day window is not being tested against any real-world constraint at the moment it is agreed to. It exists as an abstract contractual term, not yet connected to the messy reality of cross-functional decision-making, technical due diligence, and organizational change management.
The Actual Timeline for Informed Platform Switching
The process of switching email marketing platforms is not a simple vendor substitution. It requires coordination across marketing, IT, sales, legal, procurement, and finance teams, each with their own evaluation criteria, approval processes, and operational constraints. The timeline begins not with a formal decision to switch, but with the gradual recognition that the current platform is no longer adequate.
Problem recognition typically takes 30 to 45 days. The marketing team notices that a new campaign requirement cannot be implemented within the platform's automation capabilities. IT receives requests for integrations the platform does not support. The operations team identifies workflow inefficiencies that are slowing campaign execution. These observations accumulate over weeks before they coalesce into a clear consensus that the platform has become a constraint rather than an enabler. During this period, teams attempt workarounds, consult with the vendor's support team about potential solutions, and exhaust the platform's existing feature set before concluding that the limitations are structural rather than operational.
Once the problem is clearly defined, vendor evaluation begins. This phase typically requires 30 to 45 days. The marketing team documents specific functional requirements based on current pain points and anticipated future needs. IT maps out integration dependencies with the CRM, analytics platform, e-commerce system, and data warehouse. Procurement researches potential alternatives, requests demos, and collects pricing information. Scheduling demos with three to four vendors often requires two to three weeks of lead time, as vendor sales teams coordinate with their solution engineers and the customer's stakeholders align their calendars. Each demo generates follow-up questions that require additional research and internal discussion before the team can narrow the field to the most viable candidates.
The proof of concept phase adds another 30 to 45 days to the timeline. The top two candidates are given access to real customer data, existing email templates, and current automation workflows. The marketing team tests whether the new platform can replicate existing campaigns while also supporting the new requirements that prompted the evaluation. IT validates that integrations function as promised and that data flows correctly between systems. The operations team assesses whether the new interface and workflow logic are intuitive enough that the transition will not create unacceptable productivity losses during the learning curve. This testing cannot be rushed. A platform that performs well in a controlled demo environment may reveal critical limitations when confronted with the complexity and edge cases of real-world data and use cases.
Internal approval processes consume an additional 30 to 60 days. Procurement must obtain quotes from the finalists, negotiate contract terms, and compare total cost of ownership across a multi-year horizon. Legal reviews the new vendor's contract for liability clauses, data processing agreements, and termination terms. Finance evaluates whether the new platform's pricing model aligns with budget constraints and whether the migration cost can be absorbed in the current fiscal year or needs to be deferred. IT security conducts a risk assessment of the new vendor's data handling practices, infrastructure security, and compliance certifications. Each of these workstreams operates on its own timeline, and any one of them can introduce delays if concerns arise that require additional vendor clarification or internal discussion.
Finally, migration planning requires at least 30 days before the actual switch can occur. The team must map out how historical data will be transferred, how email templates will be recreated in the new platform's design system, how automation workflows will be rebuilt, and how the transition will be sequenced to minimize disruption to ongoing campaigns. IP address warm-up schedules must be developed to ensure email deliverability is maintained during the transition. Training sessions must be scheduled for the marketing team to learn the new platform's interface and capabilities.

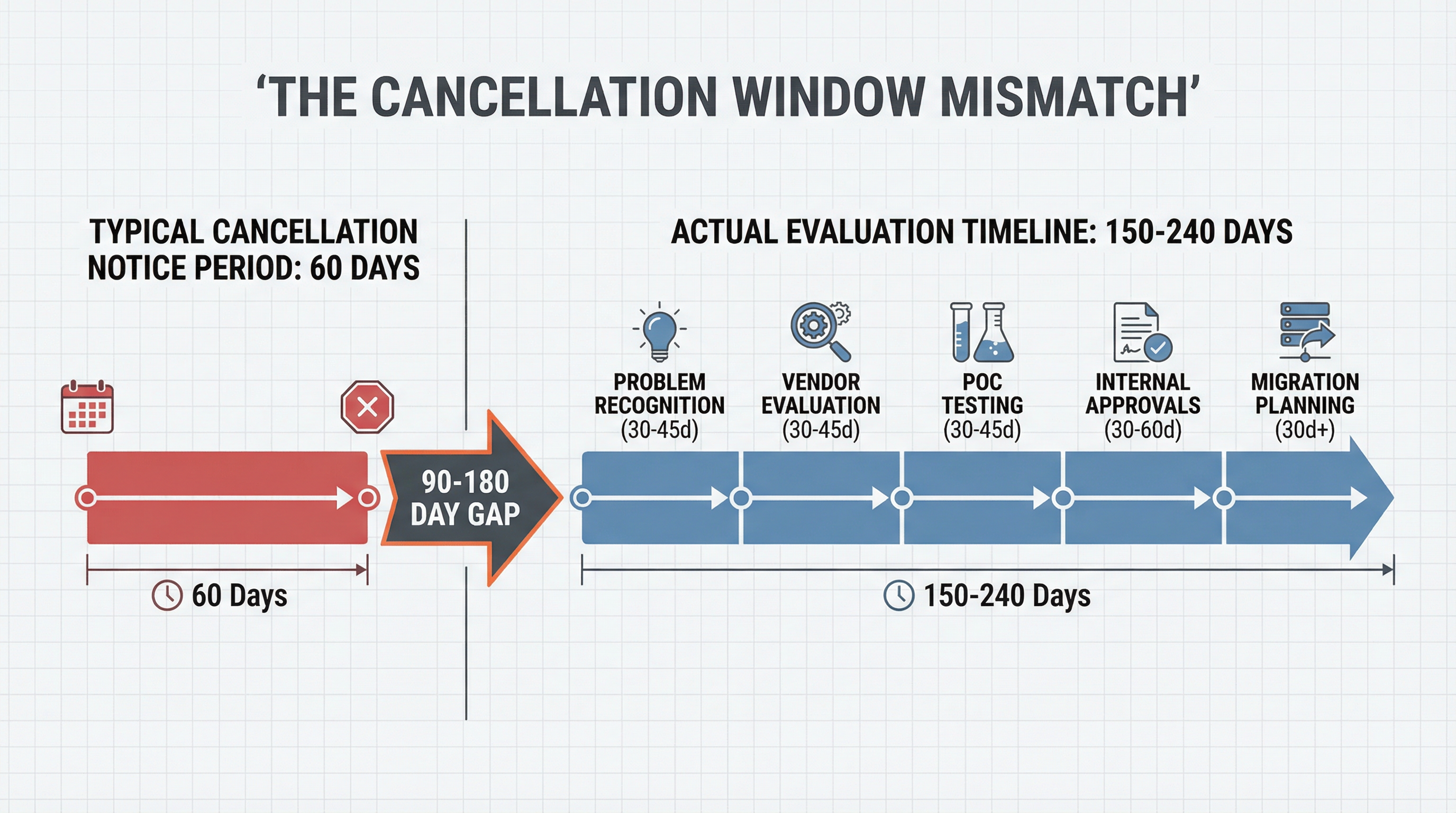

When these phases are added together, the realistic timeline from problem recognition to readiness to switch platforms ranges from 150 to 240 days. This is not a timeline inflated by organizational dysfunction or unnecessary bureaucracy. It reflects the inherent complexity of evaluating enterprise software, the coordination required across multiple stakeholders, and the due diligence necessary to avoid jumping from one inadequate platform to another.

The Structural Mismatch
The trap emerges from the collision between the 60-day cancellation notice period and the 150 to 240 day evaluation timeline. Consider the company that signed their annual contract in January. By June, six months into the contract term, the platform's limitations have become undeniable. The team immediately begins the evaluation process, recognizing that time is limited. Demos are completed by August. The proof of concept runs through September. Internal approvals are finalized in October. But the contract requires 60 days' notice before the January renewal date, which means the cancellation notice must be submitted by November 1st. The company is still in the late stages of the evaluation process when the deadline passes. They have not yet selected a replacement platform, much less completed migration planning. The cancellation window closes before the evaluation process can reach a conclusion.
Even if the team had started the evaluation process earlier, say in April rather than June, they would still face significant time pressure. An April start date provides eight months before the November cancellation deadline. But the evaluation timeline requires five to eight months under ideal conditions, and real-world complications routinely extend these timelines. A key stakeholder's vacation delays a critical approval. A vendor's proof of concept environment experiences technical issues that push back testing. Legal identifies a contract clause that requires renegotiation. Any of these common delays can push the process past the cancellation deadline.
The mismatch is structural, not operational. It is not a problem that can be solved by better project management or more aggressive timeline compression. The 60-day notice period is fundamentally shorter than the minimum time required to conduct proper due diligence on a platform switch. This creates a situation where companies must either make hasty, under-informed decisions to meet the cancellation deadline, or accept that they will be locked into another contract term even after they have determined the platform no longer serves their needs.

The trap is particularly insidious because it is invisible during the initial contract negotiation. At the moment the 60-day clause is agreed to, the company has no way to test whether it provides adequate flexibility. The clause only reveals its constraints when the company attempts to exercise it, at which point they discover that the window has already closed. By then, they are committed to another full contract term, and the cycle repeats.
The Price Uplift Multiplier
The forced renewal becomes significantly more costly when the contract includes a price increase clause. Research from Vertice indicates that 33% of SaaS vendors include language in their contracts allowing them to raise prices at renewal, and many of these clauses place no cap on the magnitude of the increase. When the renewal notice arrives in October with a 25% price increase, the company faces a painful choice. They can accept the increase and pay substantially more for a platform they know does not meet their needs, or they can attempt to negotiate the increase down while simultaneously trying to complete an evaluation process that is already behind schedule.
The price increase adds urgency to a timeline that is already compressed beyond feasibility. Procurement teams, faced with the imminent deadline, may rush through the final stages of evaluation to avoid being locked into the higher price. This rushed decision-making increases the risk of selecting a replacement platform that also proves inadequate, creating a cycle of suboptimal platform choices driven by contractual deadlines rather than thorough assessment.
Alternatively, the company may conclude that they have insufficient time to complete a proper evaluation and reluctantly accept the price increase, reasoning that one more year with a known platform, even at a higher cost, is less risky than a hasty migration to an unknown alternative. This decision is economically rational in the short term, but it compounds the sunk cost trap. The company is now paying more for a platform that does not meet their needs, which makes the cost of staying even higher, but also makes the cost of the eventual migration even more difficult to justify to finance leadership.
The price increase also eliminates one of the few sources of leverage the customer might have had in the relationship. If the vendor knows the customer has missed the cancellation deadline and is locked in for another year, there is little incentive to negotiate on price or to invest in addressing the customer's feature requests. The customer has revealed, through their inability to meet the cancellation deadline, that they are not prepared to leave, which fundamentally weakens their negotiating position.
What to Evaluate During Initial Contract Negotiation
The cancellation notice period deserves the same level of scrutiny during contract negotiation as pricing terms and service level agreements. Procurement teams should map the notice period against the realistic timeline required to evaluate alternatives, conduct proof of concept testing, secure internal approvals, and plan a migration. For most enterprise email marketing platforms, this timeline is a minimum of 120 to 180 days. Contracts that require cancellation notice periods shorter than this create structural lock-in that limits the company's ability to respond to changing needs or platform inadequacies.
Negotiating a 90 to 120 day notice period provides meaningful flexibility. Data from Vertice shows that companies starting renewal negotiations more than 90 days before the contract end date achieve 49% greater cost savings compared to those starting with less than 30 days remaining. This difference is not primarily about the negotiation itself, but about having sufficient time to develop credible alternatives. Leverage in vendor negotiations comes from the vendor's belief that the customer is prepared to leave if terms are not acceptable. That belief is only credible if the customer has actually completed an evaluation of alternatives and is operationally ready to migrate. A 90 to 120 day notice period provides the minimum time necessary to reach that state of readiness.
Removing auto-renewal clauses entirely eliminates the risk of missing a cancellation deadline. Instead of requiring the customer to affirmatively cancel within a narrow window, the contract simply expires at the end of its term unless both parties agree to renew. This shifts the default from automatic continuation to intentional renewal, which better aligns with how enterprise software decisions are actually made. Companies do not passively continue using platforms; they actively choose to renew based on ongoing assessment of value and fit. The contract structure should reflect this reality.
Capping price increases at renewal protects against the scenario where a missed cancellation deadline results in both forced renewal and a substantial price increase. A cap of 5 to 10% limits the vendor's ability to use the auto-renewal mechanism as leverage for aggressive price increases. Some contracts go further and require that any price increase above a specified threshold gives the customer a special termination right, allowing them to cancel without penalty even if they missed the standard cancellation deadline. This provision recognizes that a material price increase changes the economic terms of the relationship and should trigger a new evaluation of whether the platform remains the best option.
Including a material change clause provides an escape route if the platform's capabilities, service levels, or terms of service change in ways that undermine the original value proposition. If the vendor discontinues a feature the customer relies on, experiences repeated service outages that violate the SLA, or changes data processing terms in ways that create compliance risks, the customer should have the right to terminate without being bound by the standard cancellation notice period. This clause acknowledges that the customer's commitment to the platform is conditional on the platform continuing to deliver the capabilities and service quality that justified the original purchase decision.
Understanding the relationship between contract terms and operational flexibility is part of the broader challenge of evaluating how email marketing software pricing models actually work. Pricing structures, licensing models, and contract terms interact in ways that are not always obvious during initial evaluation, but that have significant implications for long-term costs and operational flexibility.
The cancellation notice period is not a minor administrative detail. It is a structural constraint that determines whether the company retains meaningful flexibility to respond to changing needs or platform inadequacies. Treating it as such during contract negotiation, and insisting on terms that align with the operational reality of platform evaluation timelines, is essential to avoiding the 12-month trap that results from the mismatch between contractual deadlines and decision-making processes.
